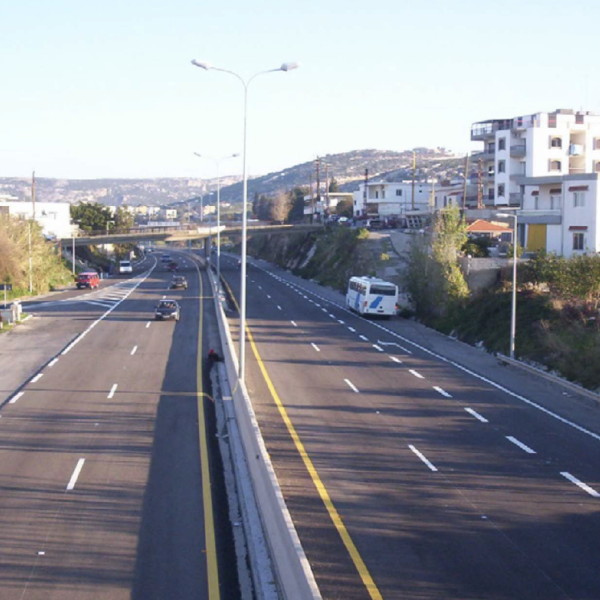

Tabarja Chekka Highway

Screenshot 2025-02-23 at 9.01.18 PM

Project Description

Client: Council for Development and Reconstruction
Location: Tabarja
Value: $26,317,170.66

Performed works:

  • Earth works.
  • Earthworks 66,000m3.
  • Base Course 77,500m3.
  • Recycled area 665,000m2.
  • Asphalt works 152,000m3.
  • Concrete works 10,000m3.
  • Construction of new jersey barriers (40 Km).
  • Construction of a storm water drainage network.
  • All kind of bridge finished works such as precast concrete parapets.
  • Expansion joints.
  • Rip rap walls.
  • Safety barriers.
  • Guard rails.
  • Curbstones.
  • Road marking.
  • Overhead gantries.
  • Traffic safety.

Khalde-Damour Highway

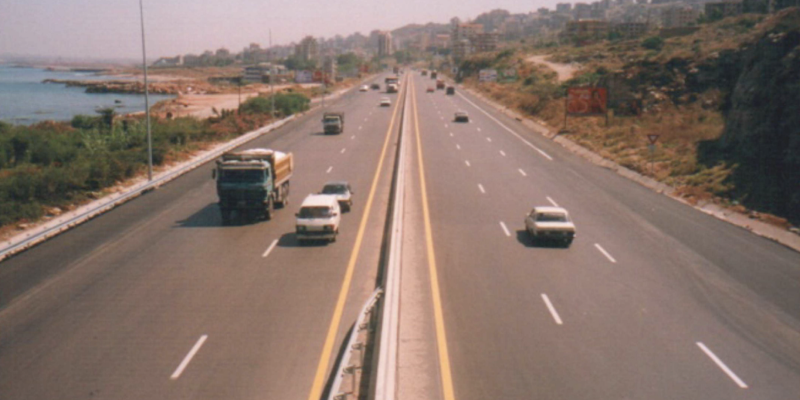

Screenshot 2025-02-23 at 8.18.00 PM

Project Description

Client: Executive Council for Major Projects (CEGP)
Location: Dammour – Khalde
Value: $6,379,986.00

Performed Works

  • Masonry walls.
  • Construction of new jersey barriers.
  • Installation of guard rails.
  • Road marking.
  • Traffic safety.
  • Earthworks 100,000m3.
  • Base Course 90,00m3.
  • Asphalt works 31,500m3.
  • Concrete works 10,000m3.

Adma Residence – 550 Building

AM_Profile_Lebanon10

Project Description

Client: Adma Residence – 550 Building
Location: Adma
Value: $4,200,000.00

ADMA 550 is located in quiet street within the Adma luxurious neighborhood, 3 minutes away from the Tripoli-Beirut highway.

Discreet, elegant in its modern facades; ADMA 550 holds only one apartment per floor with a 3.25m under ceiling height, those apartments are ranging from 300 to 500m2 including, salons, dining room and living room open to the Mediterranean sea.

The building consists of a basement, ground floor, four upper floors and attics. Each apartment has a full kitchen with logia, storage room and maids room, in addition to three master bedrooms with full bathrooms, two of them open to the evergreen Lebanese mountain and the main master bedroom opens to the Mediterranean sea.

ADMA 550 services parking spaces (700m2), a boiler plant and one storage room for each apartment at the basement level.

Other services provided include backup power generator and round the clock security.

The Numbers

Apartment Size Range: 300–500 m²
Total Floors: 6 (including basement and attics)

Abboudieh Mounjez Road

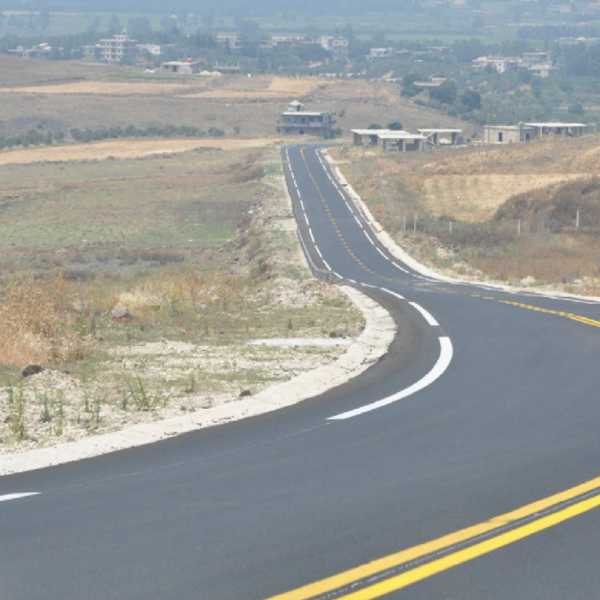

Screenshot 2025-02-23 at 3.31.22 AM

Project Description

Client: Council for Development and Reconstruction
Location: Akkar North Lebanon
Value: $17,487,928.33

The works for the Road include the construction of 14 km length of road works. The roadways section consists of 7.0 m wide pavement with 0.25 m inner verge from each side and 1.50m shoulder on each side.

The first section of this road passes by the villages of Abboudieh, Janine and Noura El Tahta village. It also has a bridge structure. The total length of this section is approximately 7Km, and the alignment crosses a mountainous terrain. The land use is in majority agricultural.

The second section begins at Noura El Tahta intersection and ends at El Dabbabieh village. The total length of this section is approximately 3.SKm.

The third section begins at El Dabbabieh village, it passes through El Fraidis and ends at El Mounjez village. The total length of this section is approximately 3.SKm. The alignment crosses a hard mountainous area and the land use is in majority semi-urban.

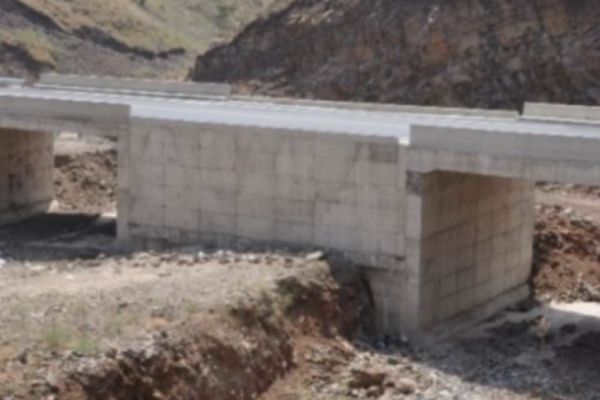

Screenshot 2025-02-23 at 3.40.21 AM

Road Works Include:

  • Site and geotechnical investigation (existing utilities, boreholes at bridges and retaining walls locations).
  • Earthworks (625,000m3) for road construction, road widening, drainage channels, culverts, bridges, walls, etc.
  • Sub-base and base course layers (106,000 m3)
  • Two Asphalt Pavement layer (52,000 Ton). Construction of retaining walls, Culverts, 4 bridges, Concrete ditches for Storm water drainage network (in total: 25,085m3 of reinforced concrete with 2,500 Ton of steel reinforcement).
  • Protection works (slope protection, drainage ditch, grouted riprap).
  • Utilities works and relocation of existing utilities.
  • Lighting works at intersections.
  • Road accessories: New Jersey Barrier, signing and marking.

Rehabilitation Of Chekka Tunnel

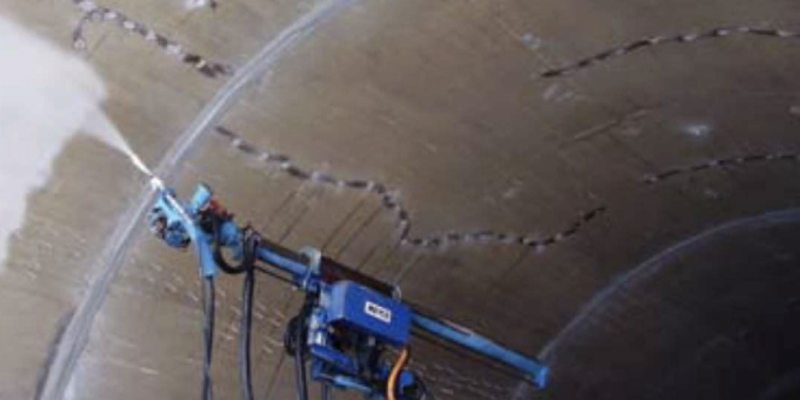

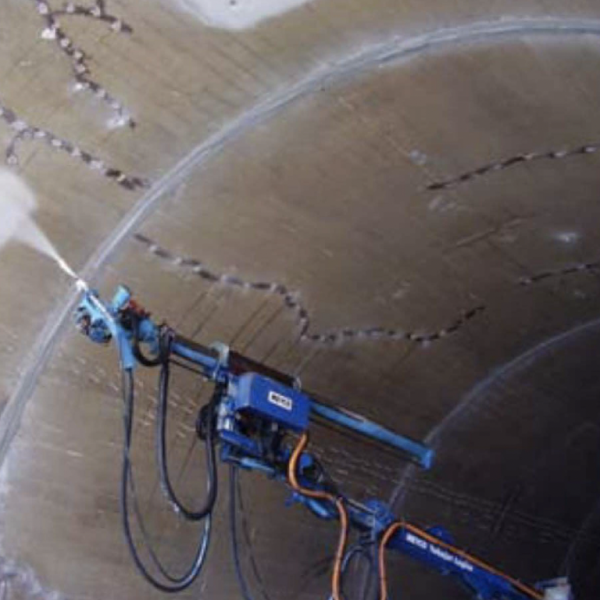

Screenshot 2025-02-23 at 2.20.56 AM

Project Description

Client: Council for Development and Reconstruction
Location: Northen Lebanon
Value: $21,134,769.63

The Chekka Road Tunnel was constructed in 1977 and comprises two parallel tubes accommodating three traffic lanes each. Each tube is 400m long and 9m wide, having an internal diameter of 12m.

The works are subdivided into following:

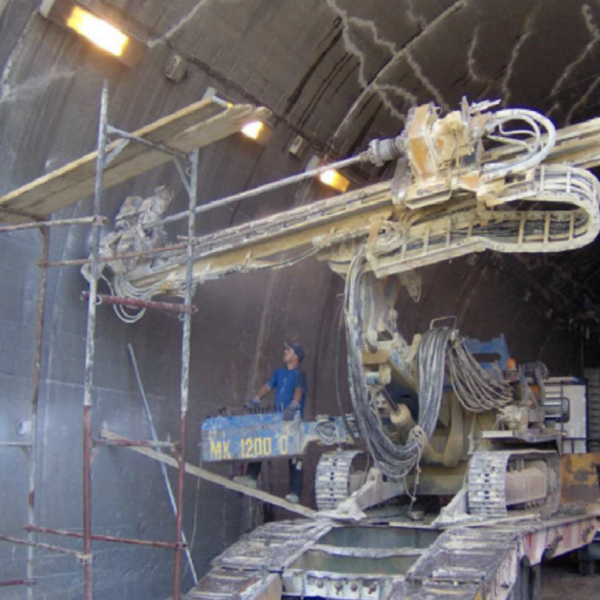

  • Exterior and Interior surface repair: A total surface of almost 18,500m2 constituting of two shells and four frames as well as an external surface which is rehabilitated as follows:
    – Internal scaffolding – Ultra high pressure water jet of all surfaces
    – Cracks sealing and injection by epoxy resin with special pumps
    – Removal of deteriorated concrete and replacing it by reinforced mortar
    – Curing reinforcement by an anti-corrosion
    – Protecting the cleaned and repaired surface by a spray able waterproofing membrane master seal-345
  • Construction of internal shotcrete jacket and a waterproofing membrane
  • Local concrete repair and construction joints repair
  • Slope stabilization
  • Water basin and drainage channels
  • Tunnel street lighting and traffic safety

The Challenge

The original refurbishment design and the tender documents called for a PVC sheet membrane for waterproofing and a final inner lining of 25cm of cast-insitu concrete.

This would impose a reduction of the interior tunnel profile, unless the original concrete lining was demolished. This would impose a technically difficult solution to implement as well as create a long construction programme.

For this reason the main contractor for the refurbishment was interested in considering an alternative technical solution which was both cost-effective and time saving.

The Results

The composite liner with the sprayable membrane proved to be a successful waterproofing system for this project. Fast and cost-effective application, as well as a precise membrane thickness and product consumption were achieved.

One of the main experiences gained was the high speed of application without compromising quality issues like consistent membrane thickness as well as safe and convenient working conditions.

The use of the same spraying robot for the waterproofing membrane and the sprayed concrete proved successful.

The UGS Solution

BASF UGC proposed the use of the sprayable waterproofing membrane MASTERSEAL® 345 in a sandwich structure between the original cast concrete and a new inner lining based on fibre reinforced sprayed.

The inner lining of sprayed concrete had a thickness of 4cm and was applied as a separate operation after installation of the sprayable waterproofing membrane. The membrane was applied in the entire tunnel profile including the walls and the crown. For aesthetic reasons a float finish of the sprayed concrete surface was carried out and tiles were applied to the walls up to the lighting level

Screenshot 2025-02-23 at 3.22.55 AM

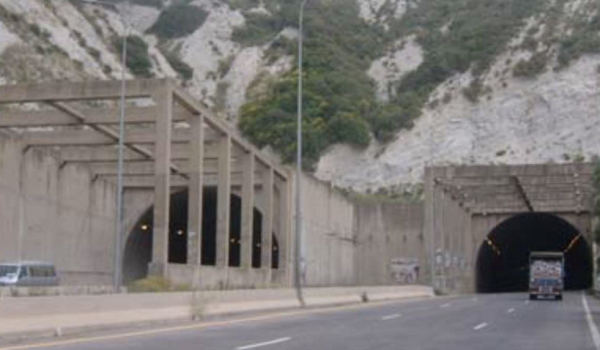

Screenshot 2025-02-23 at 3.23.41 AM

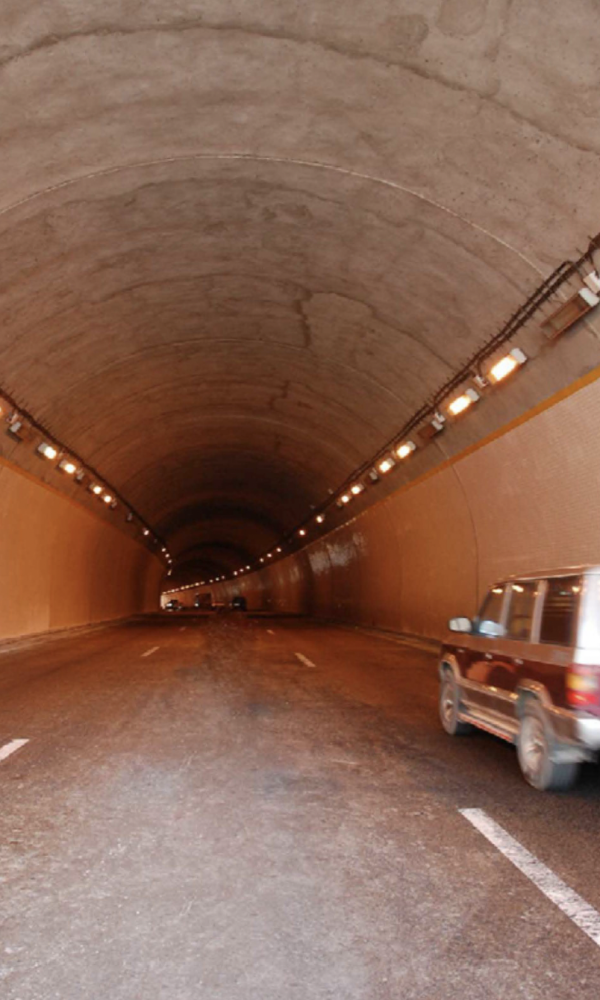

Screenshot 2025-02-23 at 3.24.23 AM

Chekka Tripoli Highway, Abou Halka Viaduct

AM_Profile_Lebanon9_2

Project Description

Client: Council for Development and Reconstruction
Location: Between Chekka and Tripoli, North Lebanon
Value: $21,134,769.63

The works include the construction of a 15.4Km length of highway Between Chekka and Tripoli North Lebanon. It’s the 3rd section of the Tabarja Tripoli highway in addition to the interchange and the boulevard of Bahsas at the South Entrance of Tripoli. The Construction of Abou Halka Viaduct was assigned under the contract for the construction of Chekka Tripoli Highway.

The Construction of Abou HALKA viaduct was assigned under the contract for construction Chekka Tripoli Highway.

The cast in situ post tension dual carriage way viaduct is 100m long and 11.75m wide. It is comprised of two traffic lanes 3.50m wide each along with the sidewalk 0.80m wide. The viaduct is laid on 14 columns (the highest being of 10m) with centering at 30m and two abutments.

The roadways section consists of 2 ways 15m wide each: an inner verge of 1.30m, 3 road lane of 11.10m wide with a 2.60 m shoulder on the right side.

This section of the Highway begins at Chekka Interchange, passes by Enfeh, Qalamoun reaching Bahsas Interchange (which is the ending point of this section). The total length of this section is approximately 15.40Km, and the alignment crosses a gently sloping terrain.

In addition,the Boulevard of Bahsas links the Coastal Road of Al Mina to the Southern Entrance ofTripoli via the Bahsas Interchange. The length of this section is soom.

Main Activities:

  • Earthworks 932,000m3.
  • Granular sub-base 200,000m3.
  • Asphalt works 195,000 Ton.
  • Concrete works 300,000m3 and reinforcing steel to 2,500 Ton.

The extent of the works includes the following main elements:

Site and geotechnical investigation (existing utilities, boreholes at Bridges, Structures, Culvert and retaining walls locations).

Earthworks (1,298,377m3) for road construction, structures, drain age channels, culverts, bridges, walls, etc. ..

Road Structure works including:

  • Sub-base and base course layers (181,749m3).
  • Two Asphalt Pavement layer (203,601 Ton).
  • Construction of 6 overpass bridges of 40m length each, 1 underpass bridge of 66m length, 1 overage exceptional of 101m length, 2x 15m wide (in total: 16342m3 of reinforced concrete with 1,401,175 Kg of steel reinforcement and 1477,190 Ton of pre-stressed reinforcement).
  • Construction of box and pipe Culvert (10,386 lm), L0,403 lm of porous drain, 25,906 lm of concrete ditches for Storm water drainage network. Construction of 2,755m2 of reinforced earth Walls (in total 45,123m3 of selected fill with 53,518m of armature).
  • Protection works (slope protection, drainage ditch, grouted riprap).
  • Street Lighting works.
  • Utilities works and relocation of existing utilities.
  • Road and bridges accessories: 14 Km of New Jersey Barrier, Guard rails, signing and marking.
Screenshot 2025-02-23 at 1.19.22 AM

Construction of Reinforced Earth Wall

Screenshot 2025-02-23 at 1.22.03 AM

Installation Of Reinforced Earth Wall Panels

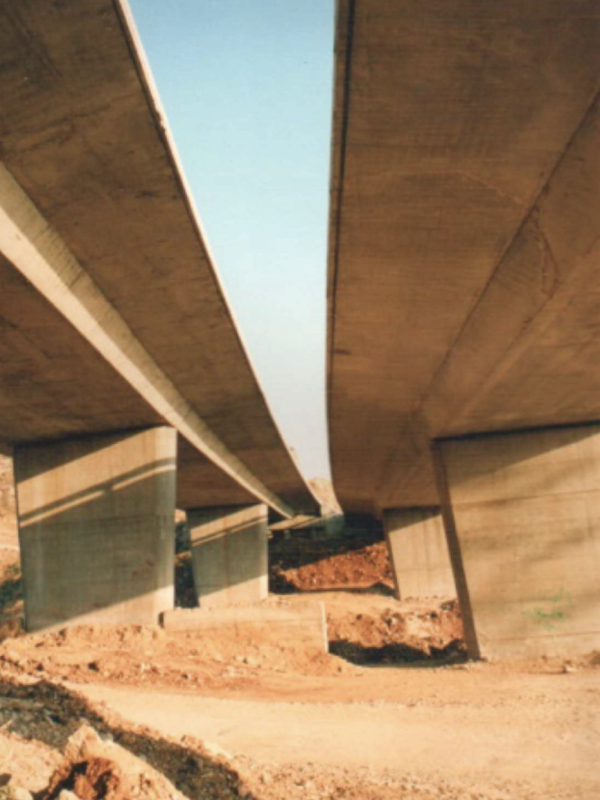

Screenshot 2025-02-23 at 1.24.37 AM

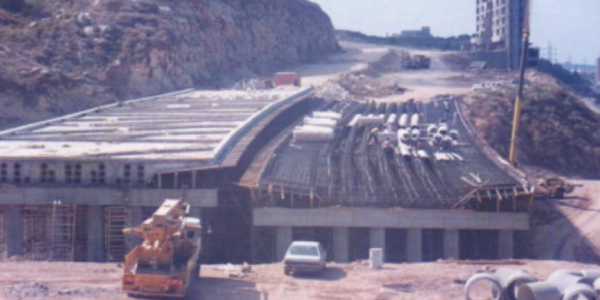

Over Pass Bridge

Screenshot 2025-02-23 at 1.25.49 AM

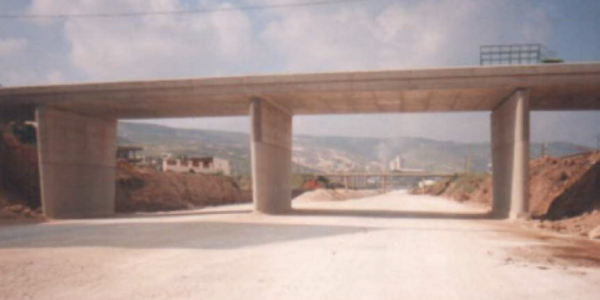

Construction Of Bridge Deck

Screenshot 2025-02-23 at 1.35.39 AM

Construction Of Over Pass Bridge

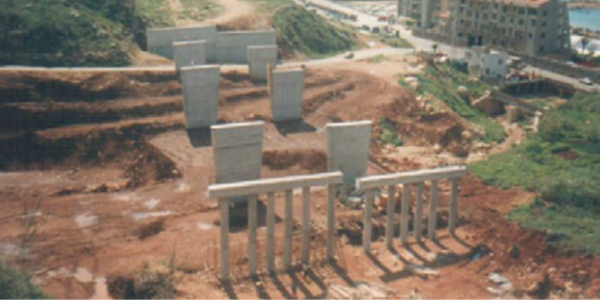

Screenshot 2025-02-23 at 2.06.08 AM

Bridge Pier

Screenshot 2025-02-23 at 2.15.24 AM

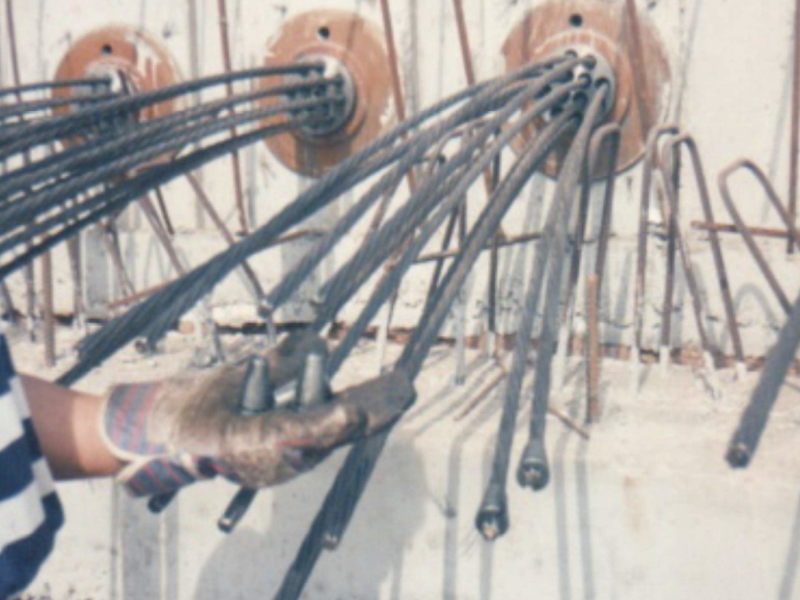

Post Tension

Screenshot 2025-02-23 at 2.15.14 AM

Road final shape - Steel guard rail - Wearing course - Edge marking yellow line

Repair Works of Naher Beirut Bridge and Highway

Project Description

Client: Council for Development and Reconstruction
Location: Beirut
Value: $4,124,931.23

Lowering the road level under Naher Beirut Bridge. Demolition of existing triple cell culvert and lowering the concrete leve and execution of new double cell culvert length 400lm, and all related road works.

Main Activities

  • Excavation 24,496m3.
  • Base course 6,182m3.
  • Wearing course 6,074m3.
  • Concrete 5,360m3.
  • Steel 840 Ton.
  • Carbon fiber 120lm.
  • Curbstones 6,400lm.
  • Tiling 5,500lm.

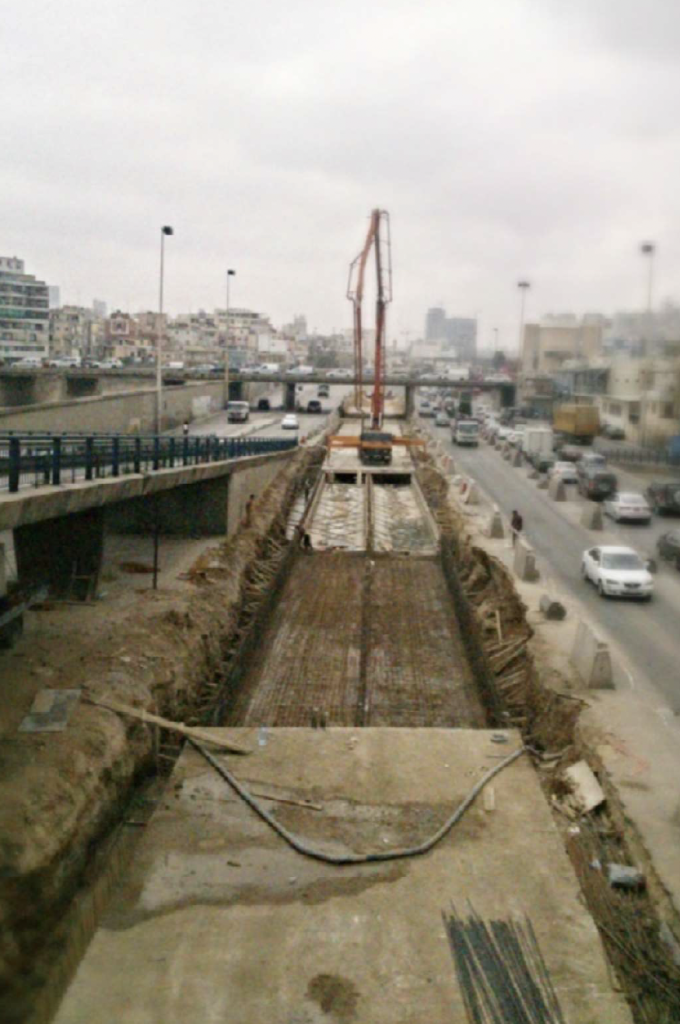

Screenshot 2025-02-23 at 12.40.35 AM

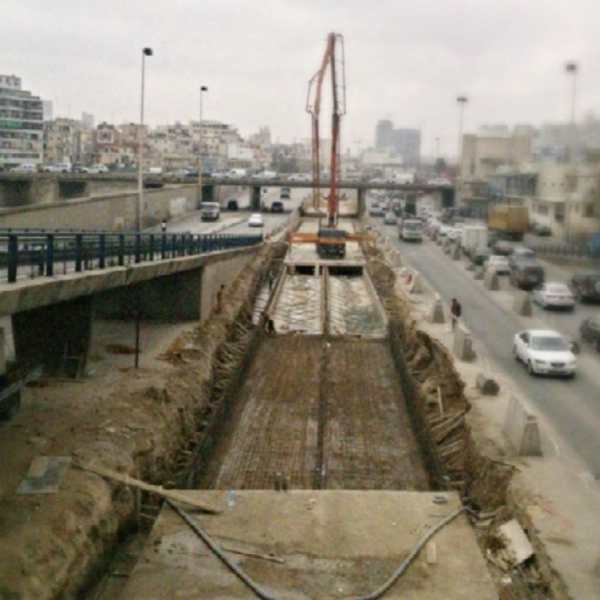

Before

Screenshot 2025-02-23 at 12.47.33 AM

After

Screenshot 2025-02-23 at 12.49.39 AM

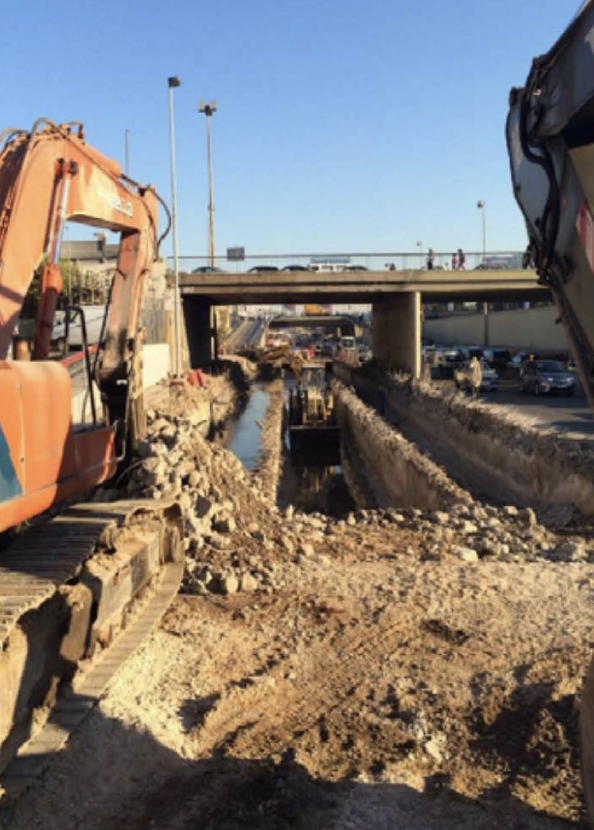

Demolition of existing box culvert

Screenshot 2025-02-23 at 12.50.40 AM

Asphalt-milling

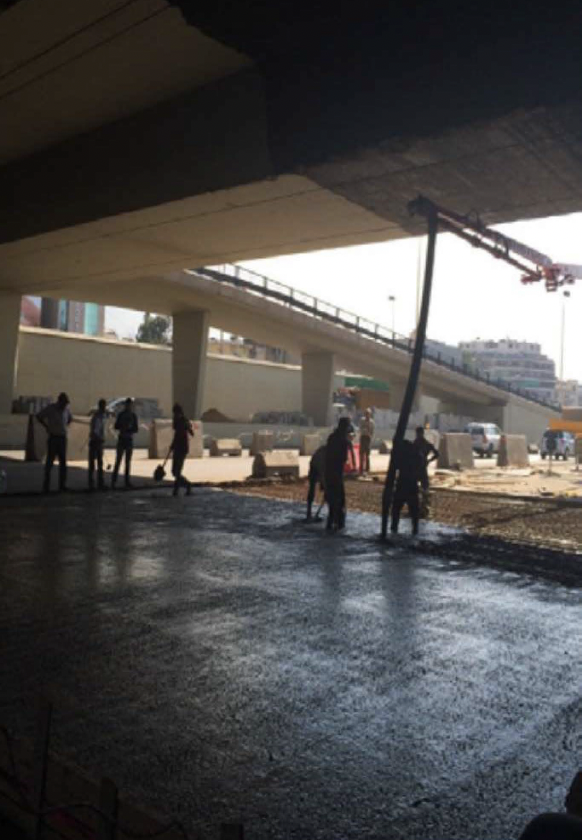

Screenshot 2025-02-23 at 12.51.40 AM

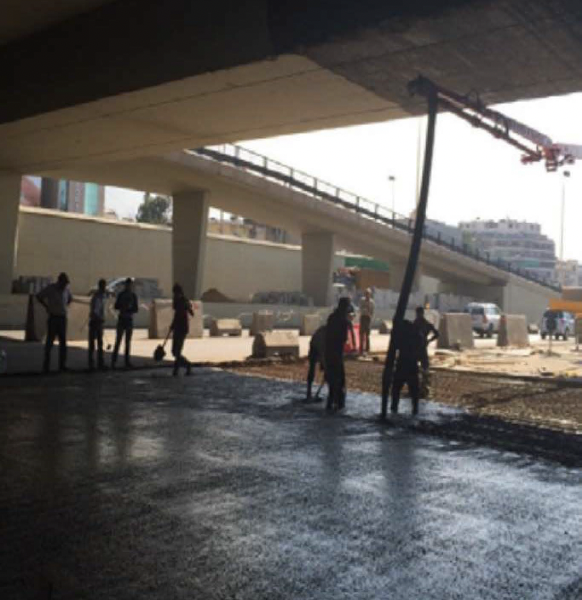

Concreting of boxculvert top slab

Sir El Danniyeh Jbal El Homr Road

AM_Profile_Lebanon7

Project Description

Client: Council For Development And Reconstruction
Location: Sir El Dannyeh To Jbab El Homr (Hermel Bekaa, North Lebanon)
Value: $18,124,359.44

The works include the construction of 28Km long of completely new roads and the Rehabilitation of a 9.5Km long of existing road. The roadways section consists of a 7m wide pavement with a 1m shoulder on each side.

The first section of this road passes by the village of Nabaa Al Sukkar, Brisa, Jbal Al Homer the ending point of this section. The total length of this section is approximately 25Km, and the alignment crosses a mountainous terrain.

The second section begins at Jbal Al Homer and ends at the road to Hermel village in the Bekaa Valley. The total length of th is section is approximately 3.2Km. The alignment crosses also a mountainous terrain.

The third section is a link section between Sir el Danniyeh village, and the beginning of the project at Nabaa Al Sukkar. The total length of this section is approximately 9.5Km. The alignment crosses a hard mountainous area and the land use is in majority agricultural.

RIW in Various Areas of Greater Doha

AM_Profile_Qatar1

Works comprises of construction of temporary / permanent roads including supply & apply of prime and tack coat, flexible surfacing, kerbing, concrete pipe culverts, installation of traffic signs, construction of speed humps and road marking works

Project Description

Client: Public Works Authority (Ashghal)
Location: Doha
Year Completed: Not Provided
Value: $3,904,781.59

Construction of temporary roads with comprehensive asphalt laying works including prime coat and road marking applications.

The Challenges

Coordinating road works in multiple urban areas with varying traffic demands.
